Agilität im Systems Engineering – geht das?HOOD Group
Agilität hat erstmal nichts mit dem Entwicklungsgegenstand zu tun.
Agil zu sein, bedeutet für uns: Wir orientieren uns an den Werten und Prinzipien des agilen Manifests.
Agilität beginnt im Kopf…!
Mein Scrum ist kaputt und das Meeting passt leider nicht und die Rollen sind auch nicht gut verteilt. Wie agile Softwarentwicklung mit Scrum funktionieren kann, zeigt Ulf Mewe von der HEC Gmbh.
Ähnlich wie Agile softwareentwicklung am Beispiel von Scrum (20)
2. Vorstellung
Zeljko Kvesic
Leiter Entwicklung & Systeme
mission-one GmbH
www.mission-one.de
Mostar, Bosnien und Herzegowina
zeljko@kvesic.de
Twitter: @nadrealista
Web: www.kvesic.de

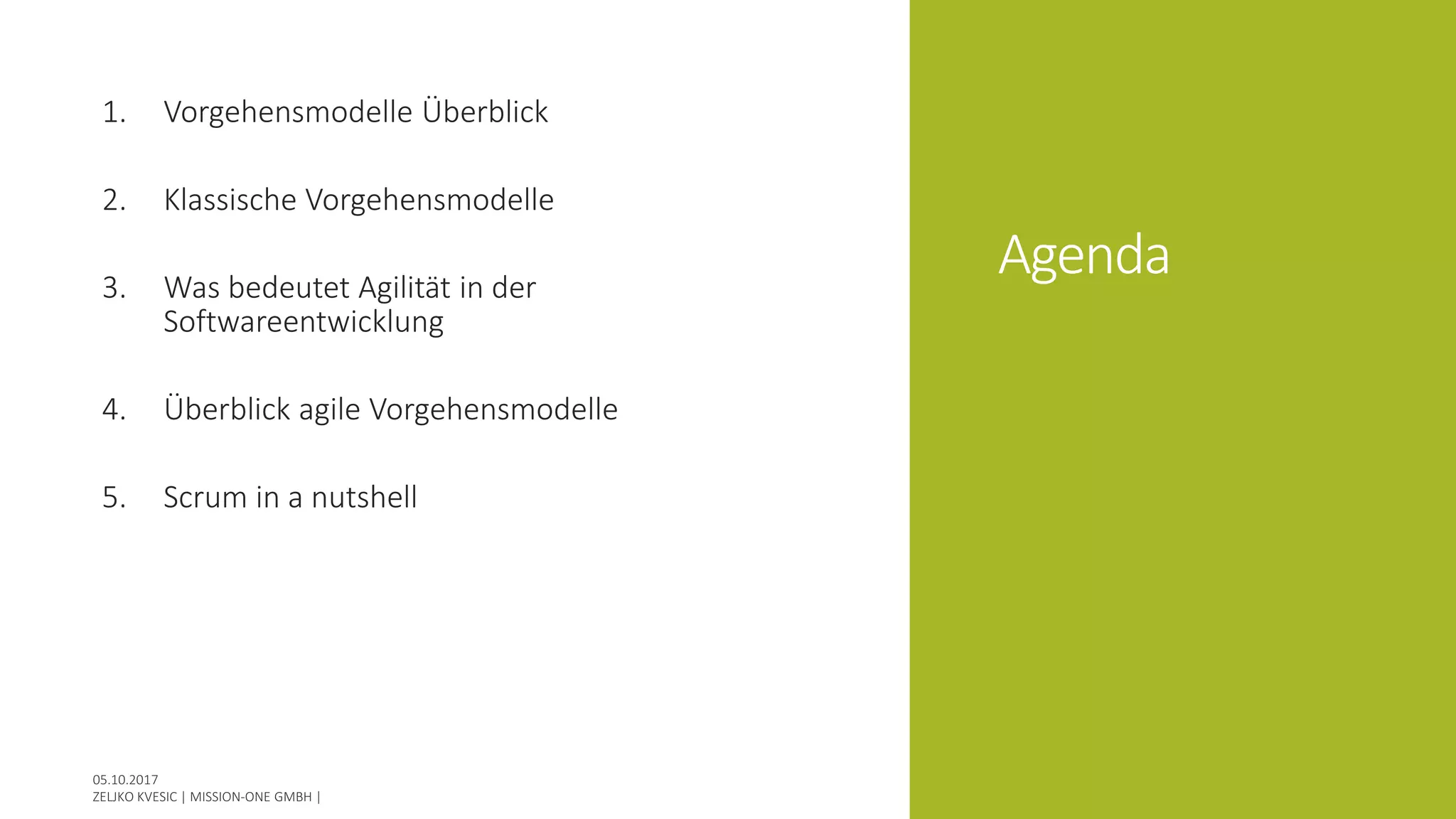

3. Agenda

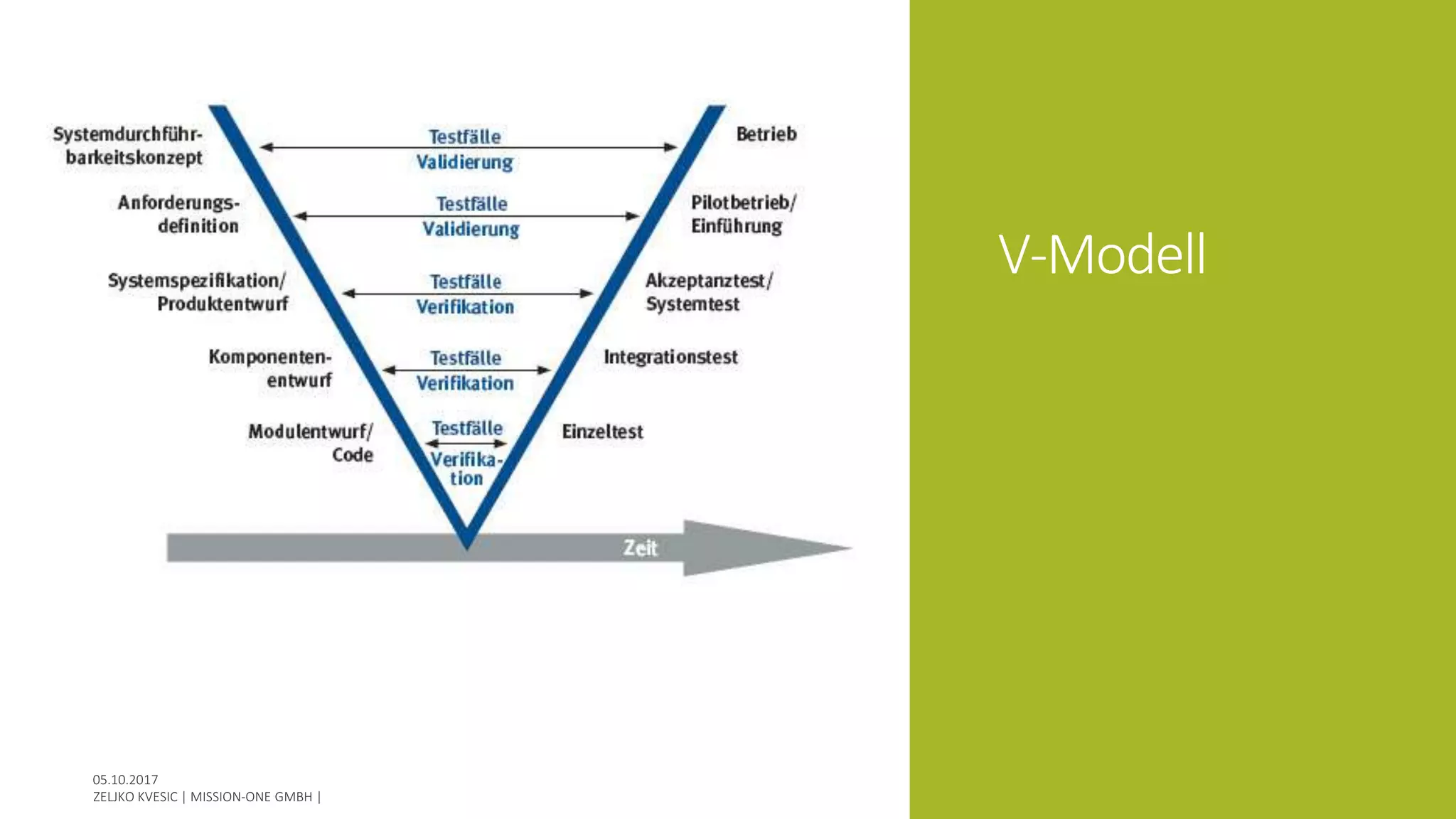

1. Vorgehensmodelle Überblick
2. Klassische Vorgehensmodelle
3. Was bedeutet Agilität in der
Softwareentwicklung
4. Überblick agile Vorgehensmodelle
5. Scrum in a nutshell

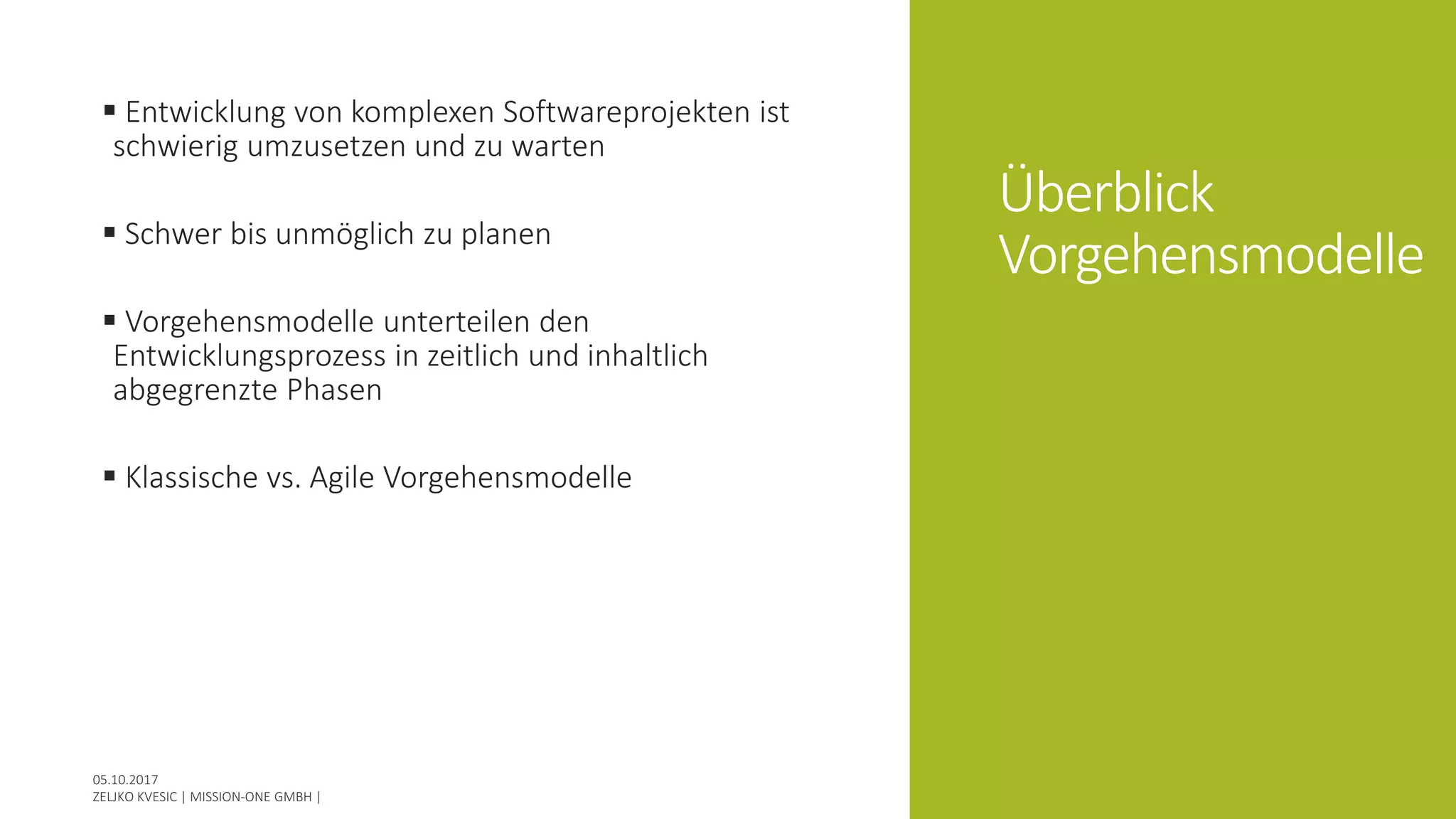

4. Überblick
Vorgehensmodelle
Entwicklung von komplexen Softwareprojekten ist
schwierig umzusetzen und zu warten
Schwer bis unmöglich zu planen
Vorgehensmodelle unterteilen den
Entwicklungsprozess in zeitlich und inhaltlich
abgegrenzte Phasen

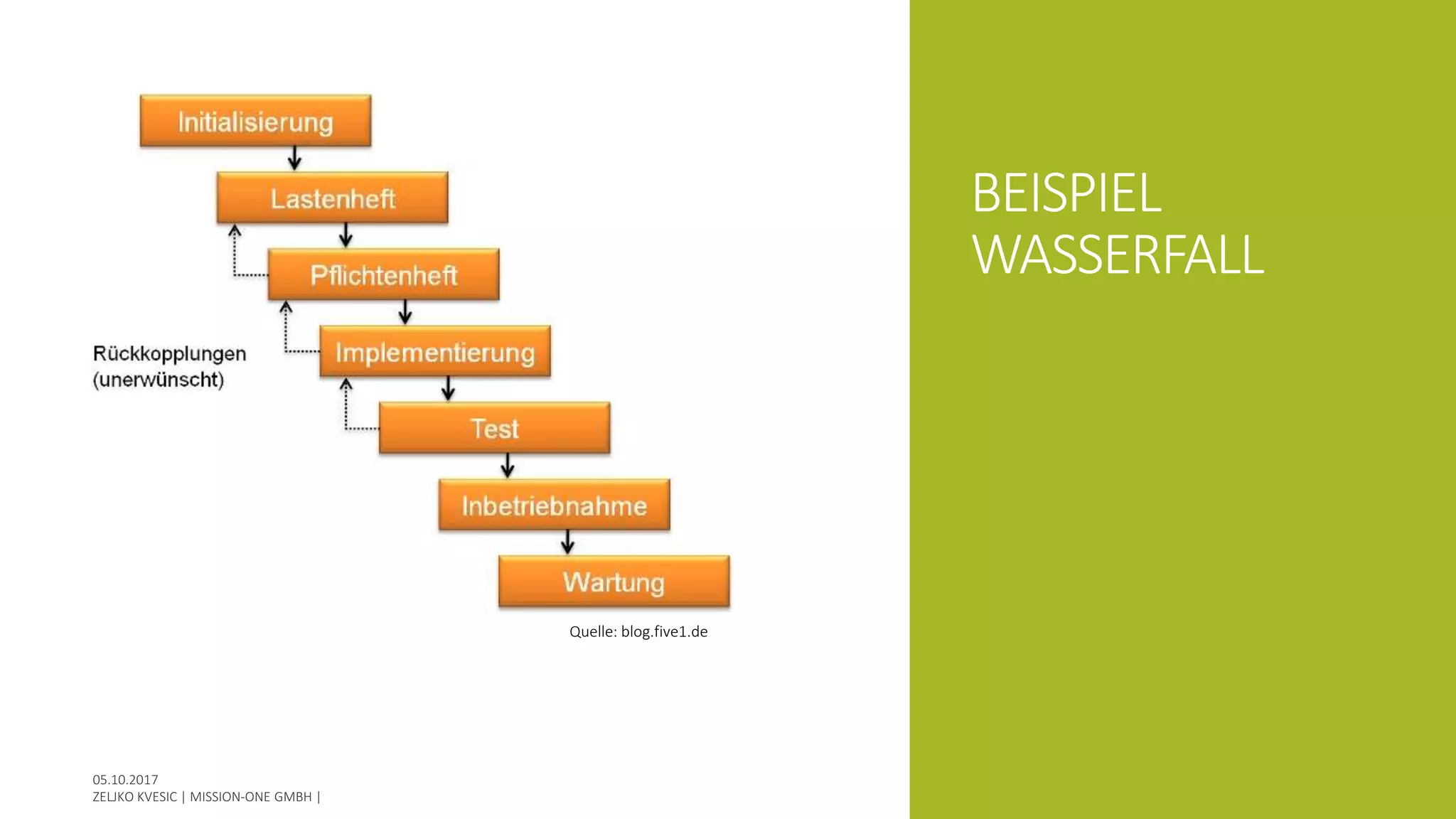

Klassische vs. Agile Vorgehensmodelle
8. AGILE

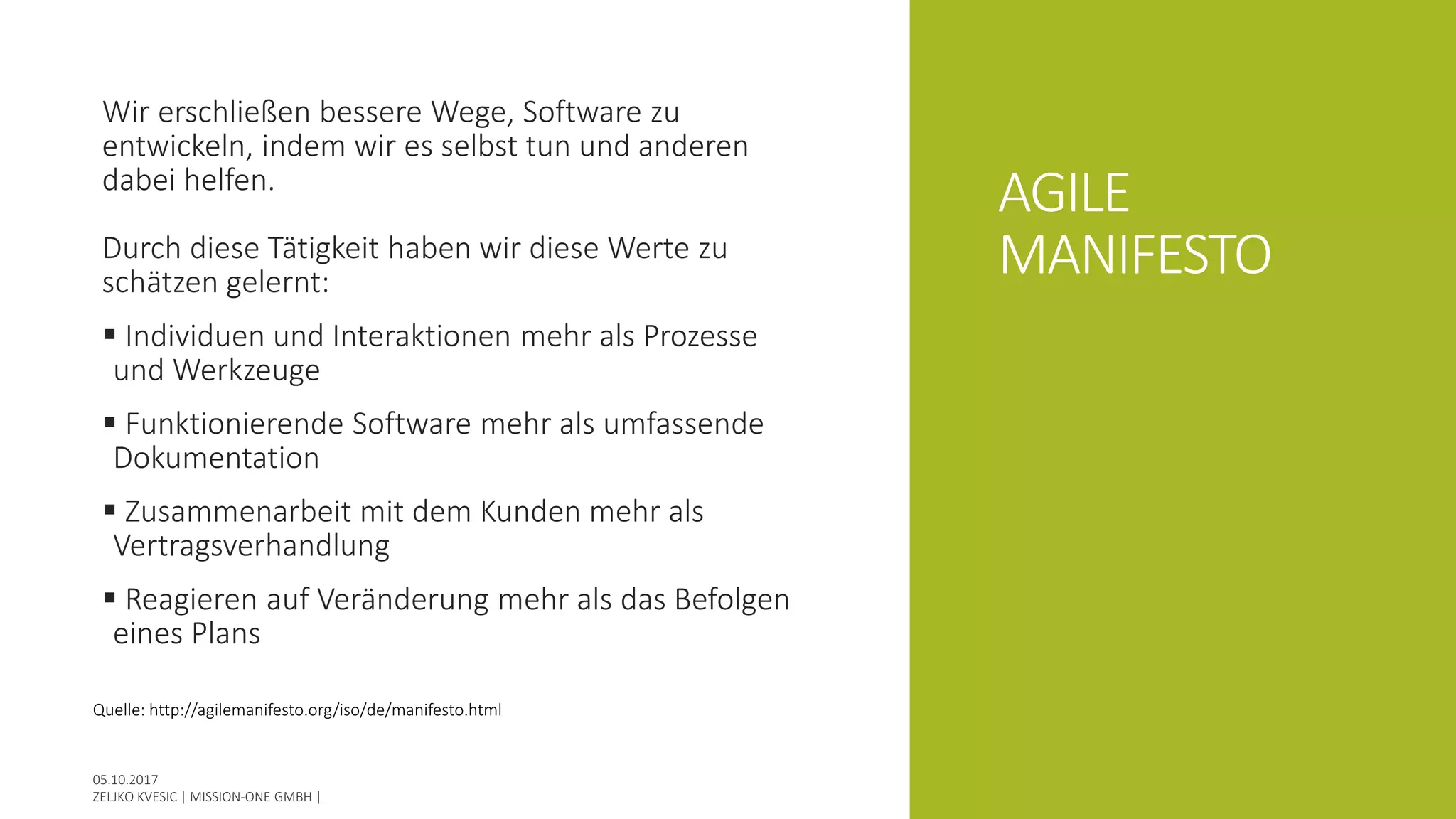

MANIFESTO
Wir erschließen bessere Wege, Software zu
entwickeln, indem wir es selbst tun und anderen
dabei helfen.
Durch diese Tätigkeit haben wir diese Werte zu
schätzen gelernt:
Individuen und Interaktionen mehr als Prozesse
und Werkzeuge
Funktionierende Software mehr als umfassende
Dokumentation
Zusammenarbeit mit dem Kunden mehr als
Vertragsverhandlung
Reagieren auf Veränderung mehr als das Befolgen
eines Plans
Quelle: http://agilemanifesto.org/iso/de/manifesto.html

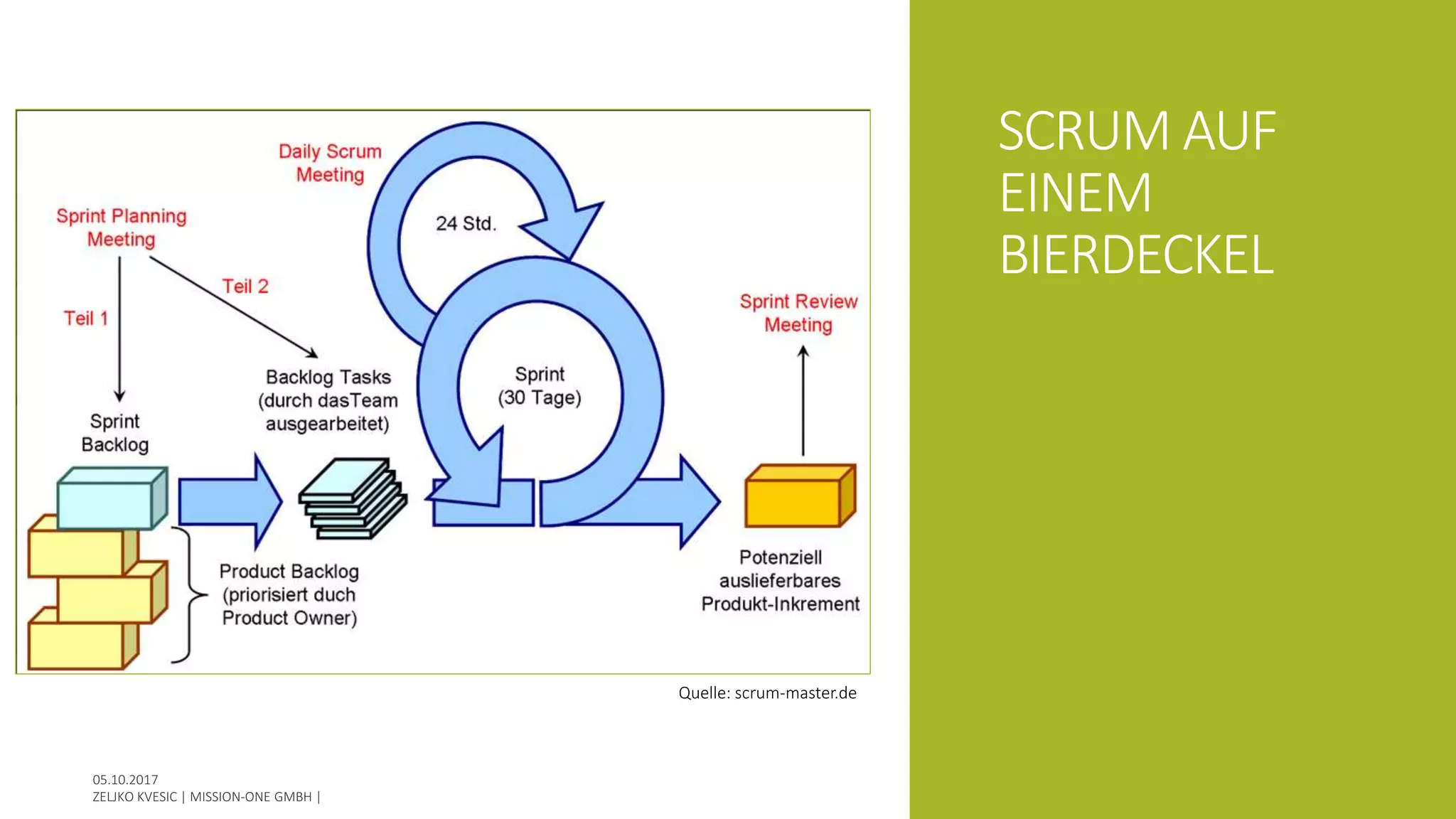

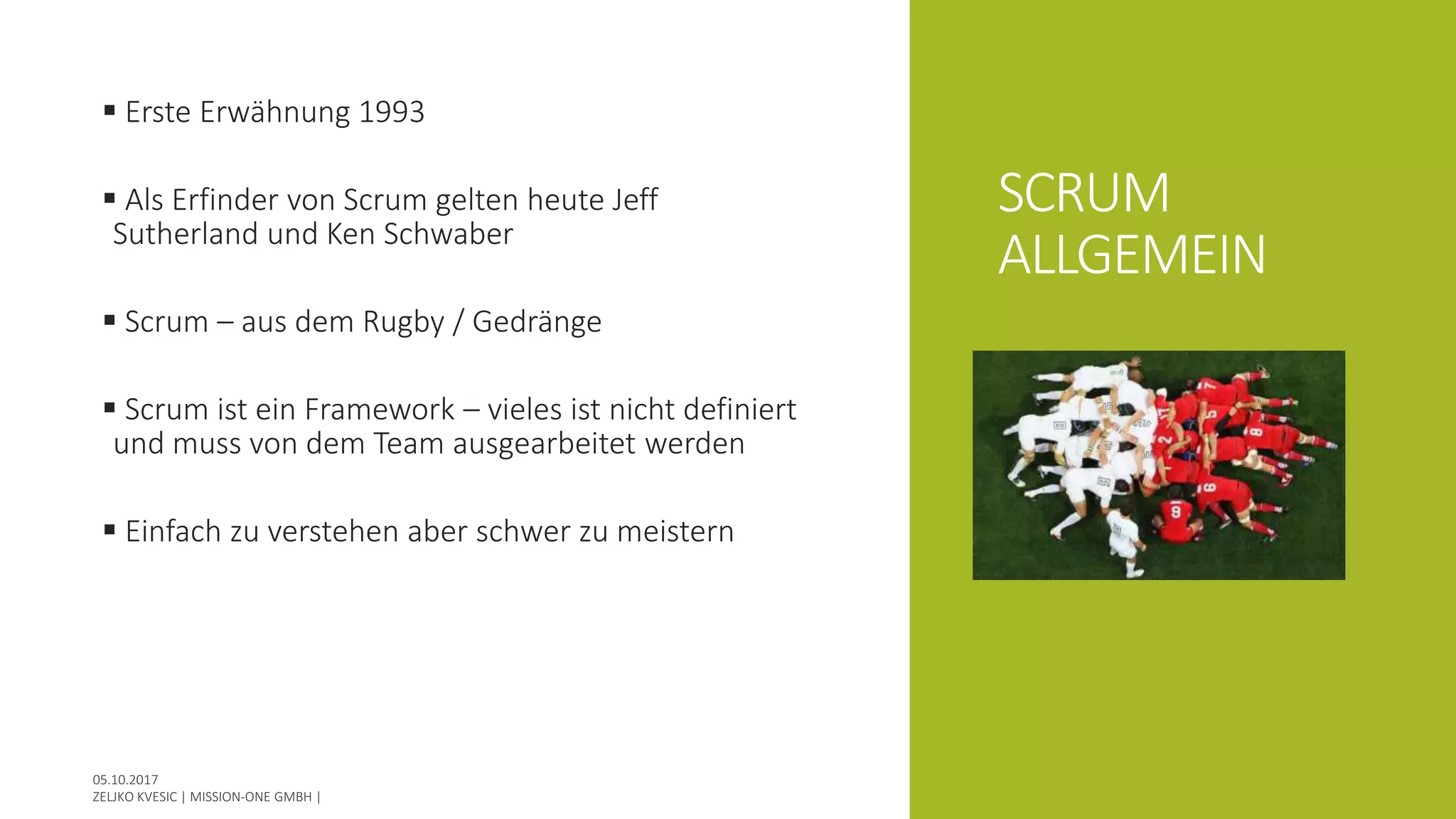

9. SCRUM
ALLGEMEIN
Erste Erwähnung 1993
Als Erfinder von Scrum gelten heute Jeff
Sutherland und Ken Schwaber
Scrum – aus dem Rugby / Gedränge
Scrum ist ein Framework – vieles ist nicht definiert
und muss von dem Team ausgearbeitet werden
Einfach zu verstehen aber schwer zu meistern

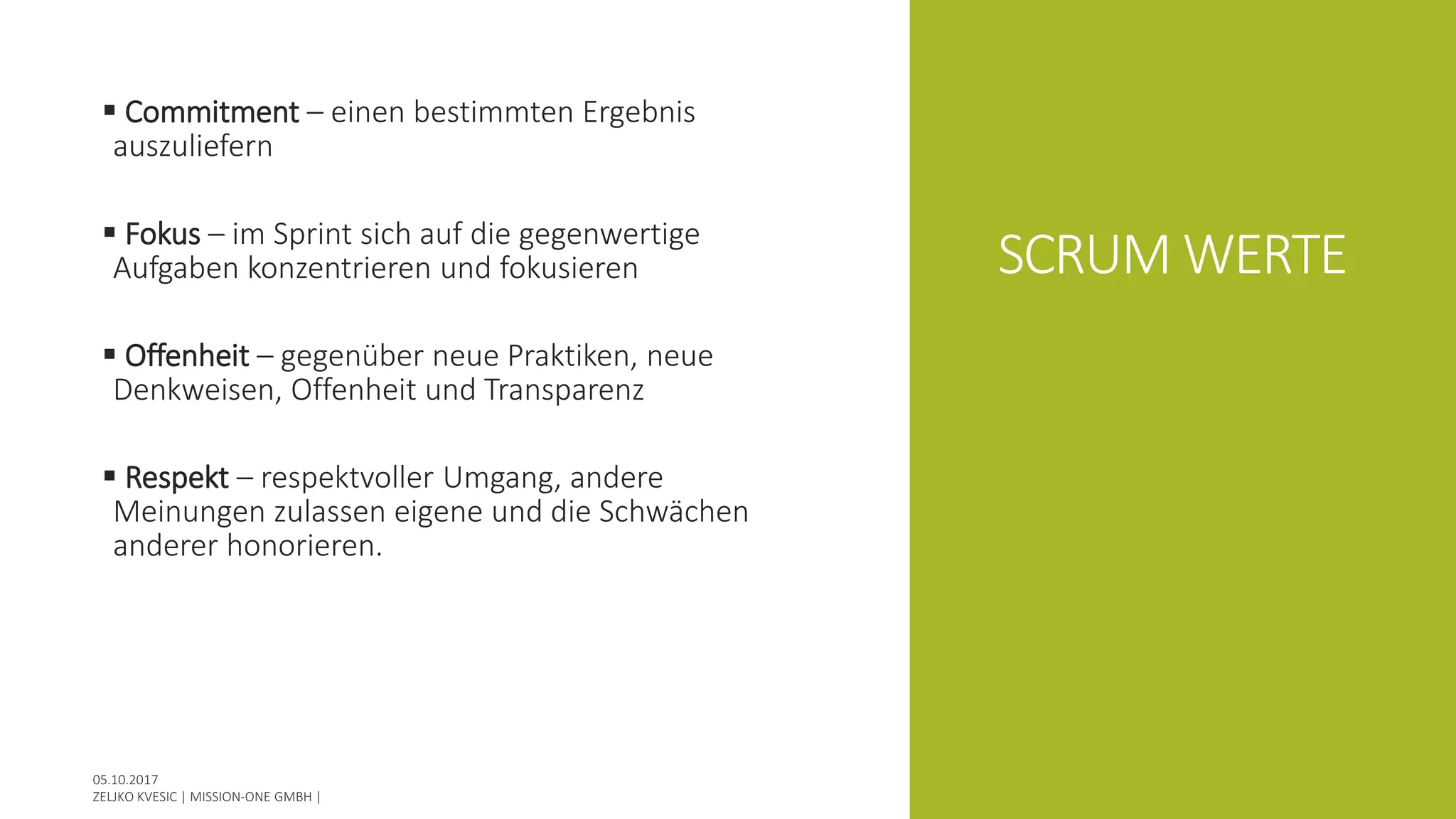

10. SCRUM WERTE
Commitment – einen bestimmten Ergebnis
auszuliefern
Fokus – im Sprint sich auf die gegenwertige
Aufgaben konzentrieren und fokusieren
Offenheit – gegenüber neue Praktiken, neue
Denkweisen, Offenheit und Transparenz
Respekt – respektvoller Umgang, andere
Meinungen zulassen eigene und die Schwächen
anderer honorieren.

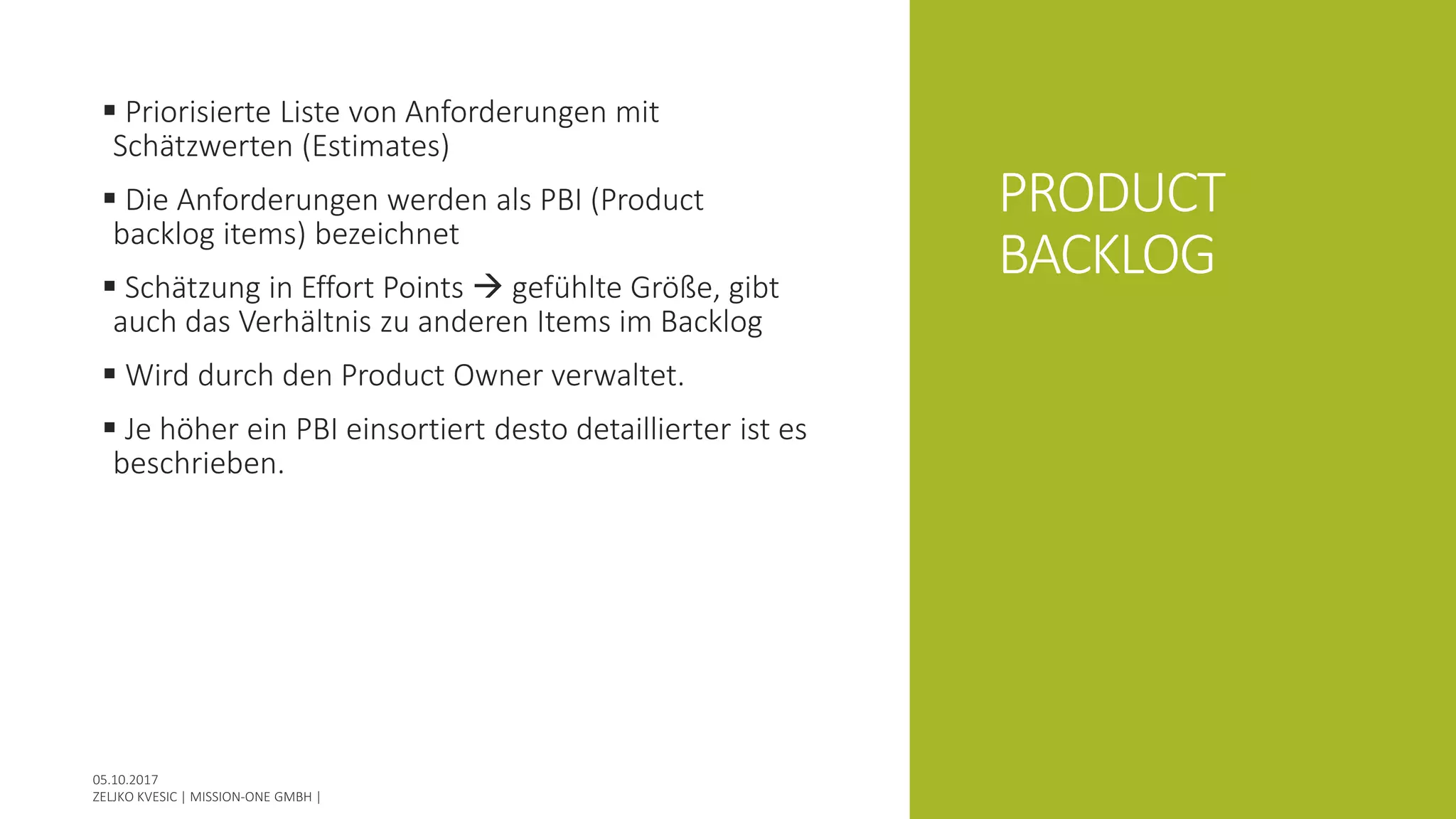

12. PRODUCT
BACKLOG
Priorisierte Liste von Anforderungen mit
Schätzwerten (Estimates)
Die Anforderungen werden als PBI (Product
backlog items) bezeichnet
Schätzung in Effort Points gefühlte Größe, gibt
auch das Verhältnis zu anderen Items im Backlog
Wird durch den Product Owner verwaltet.
Je höher ein PBI einsortiert desto detaillierter ist es
beschrieben.
13. SPRINT
BACKLOG
Liste von PBI´s und Tasks die den Arbeitsumfang
vom aktuellen Sprint festlegt.
Wird täglich von allen Mitgliedern vom Scrum
Team gepflegt.
Gibt Einblick in den Fortschritt der Arbeit im
aktuellen Sprint (Burndown Chart)

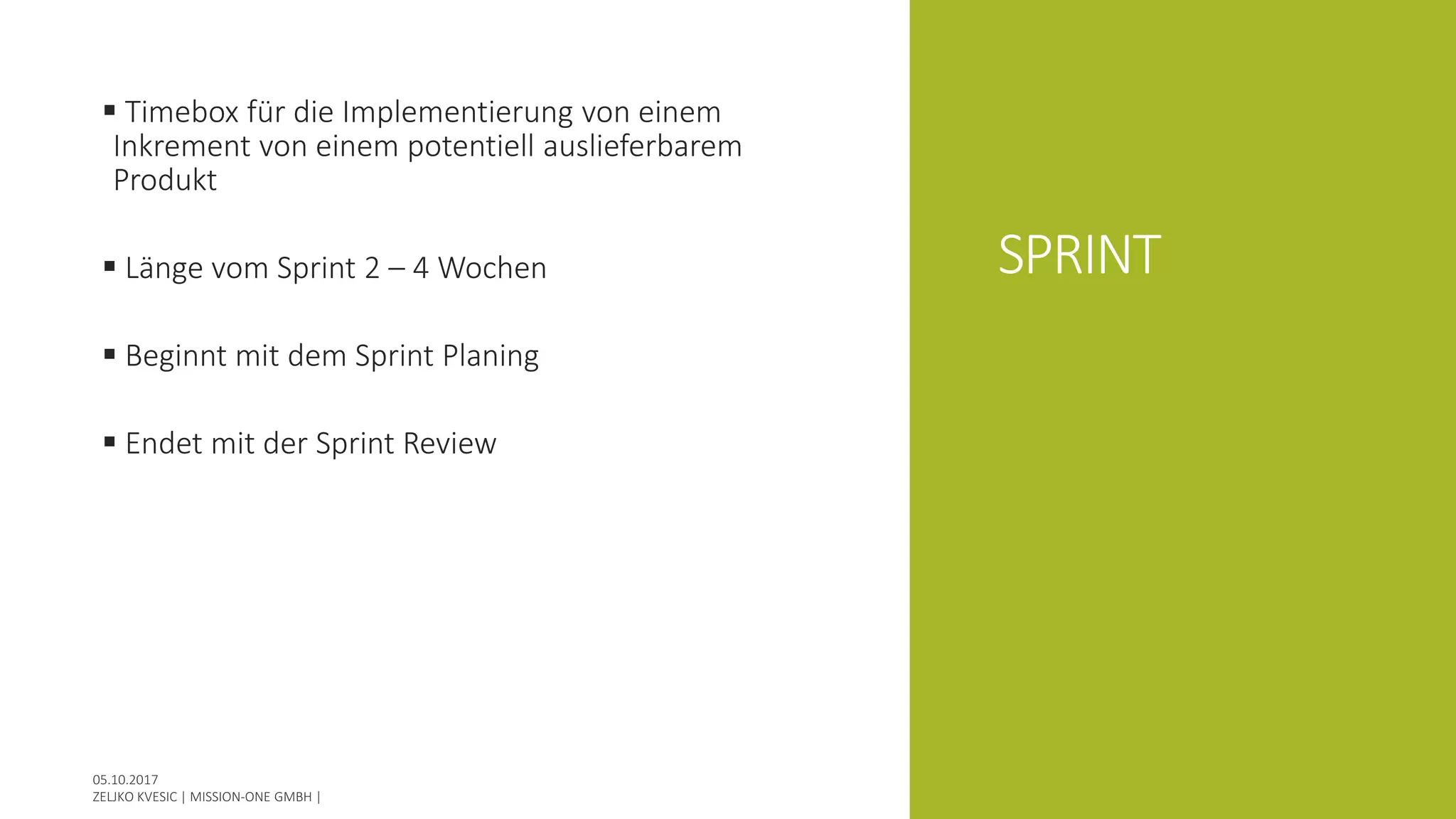

14. SPRINT
Timebox für die Implementierung von einem
Inkrement von einem potentiell auslieferbarem
Produkt
Länge vom Sprint 2 – 4 Wochen
Beginnt mit dem Sprint Planing
Endet mit der Sprint Review

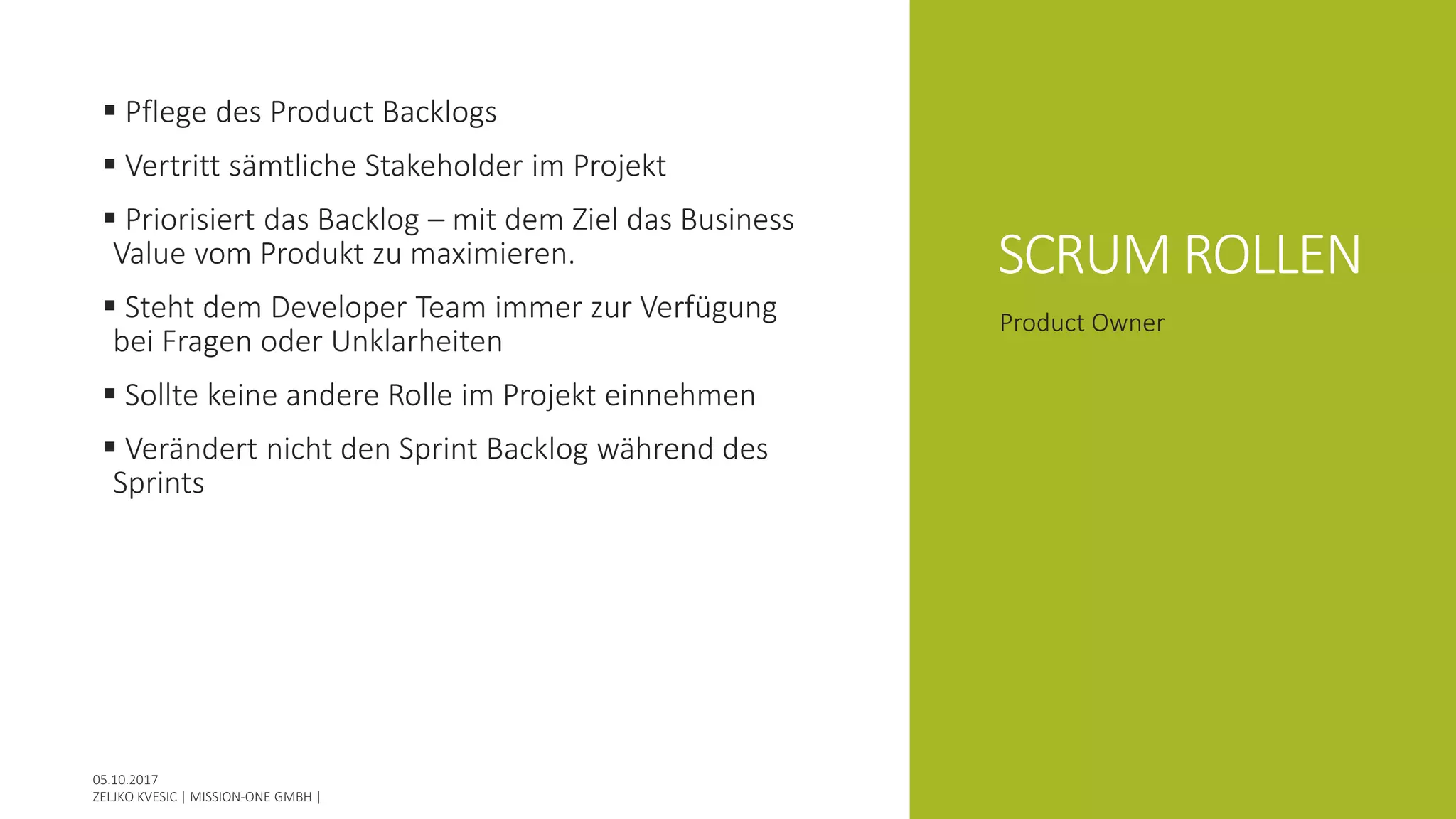

15. SCRUM ROLLEN
Pflege des Product Backlogs
Vertritt sämtliche Stakeholder im Projekt
Priorisiert das Backlog – mit dem Ziel das Business
Value vom Produkt zu maximieren.
Steht dem Developer Team immer zur Verfügung
bei Fragen oder Unklarheiten
Sollte keine andere Rolle im Projekt einnehmen
Verändert nicht den Sprint Backlog während des
Sprints
Product Owner

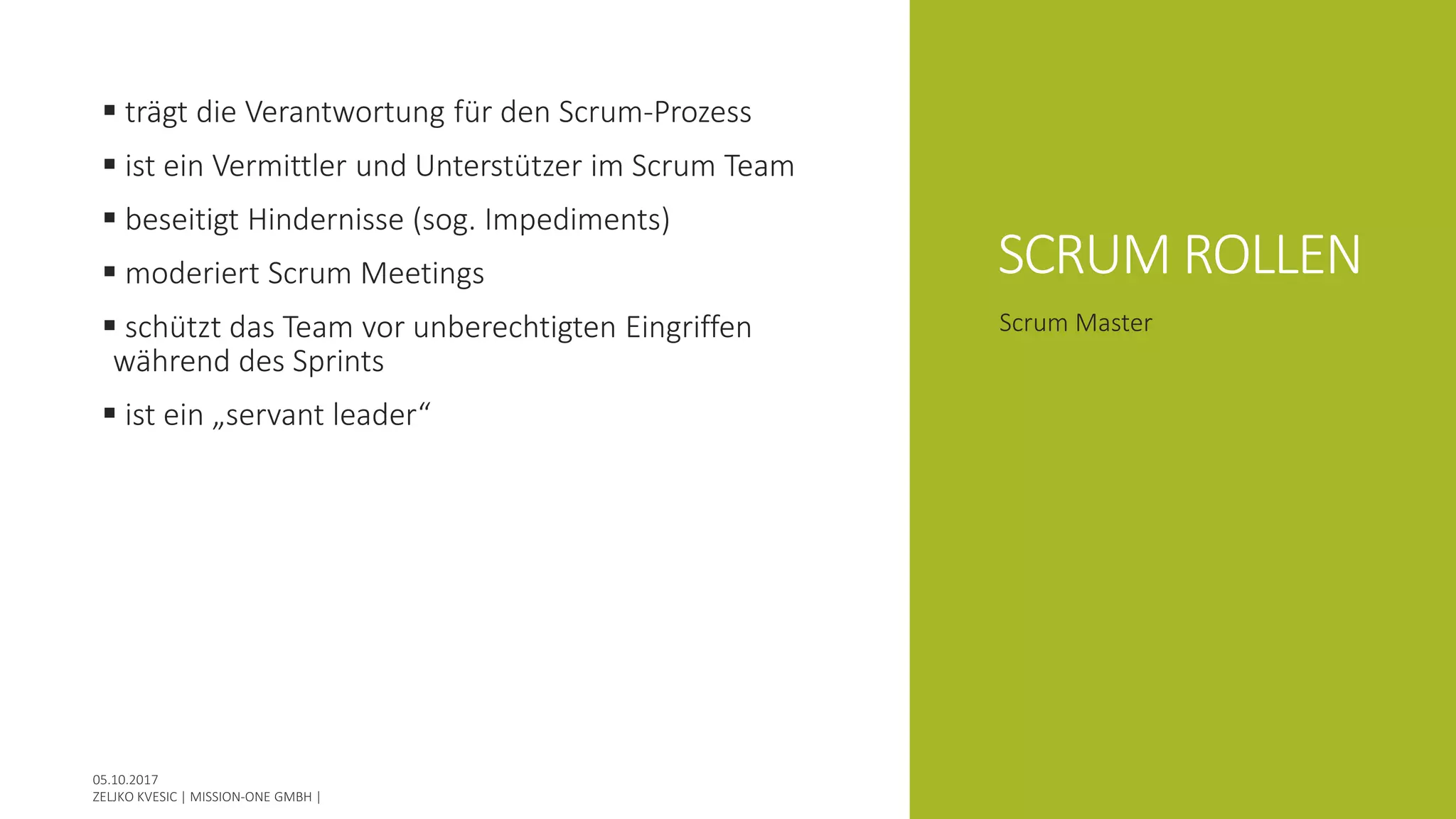

16. SCRUM ROLLEN
trägt die Verantwortung für den Scrum-Prozess
ist ein Vermittler und Unterstützer im Scrum Team
beseitigt Hindernisse (sog. Impediments)
moderiert Scrum Meetings
schützt das Team vor unberechtigten Eingriffen
während des Sprints
ist ein „servant leader“
Scrum Master

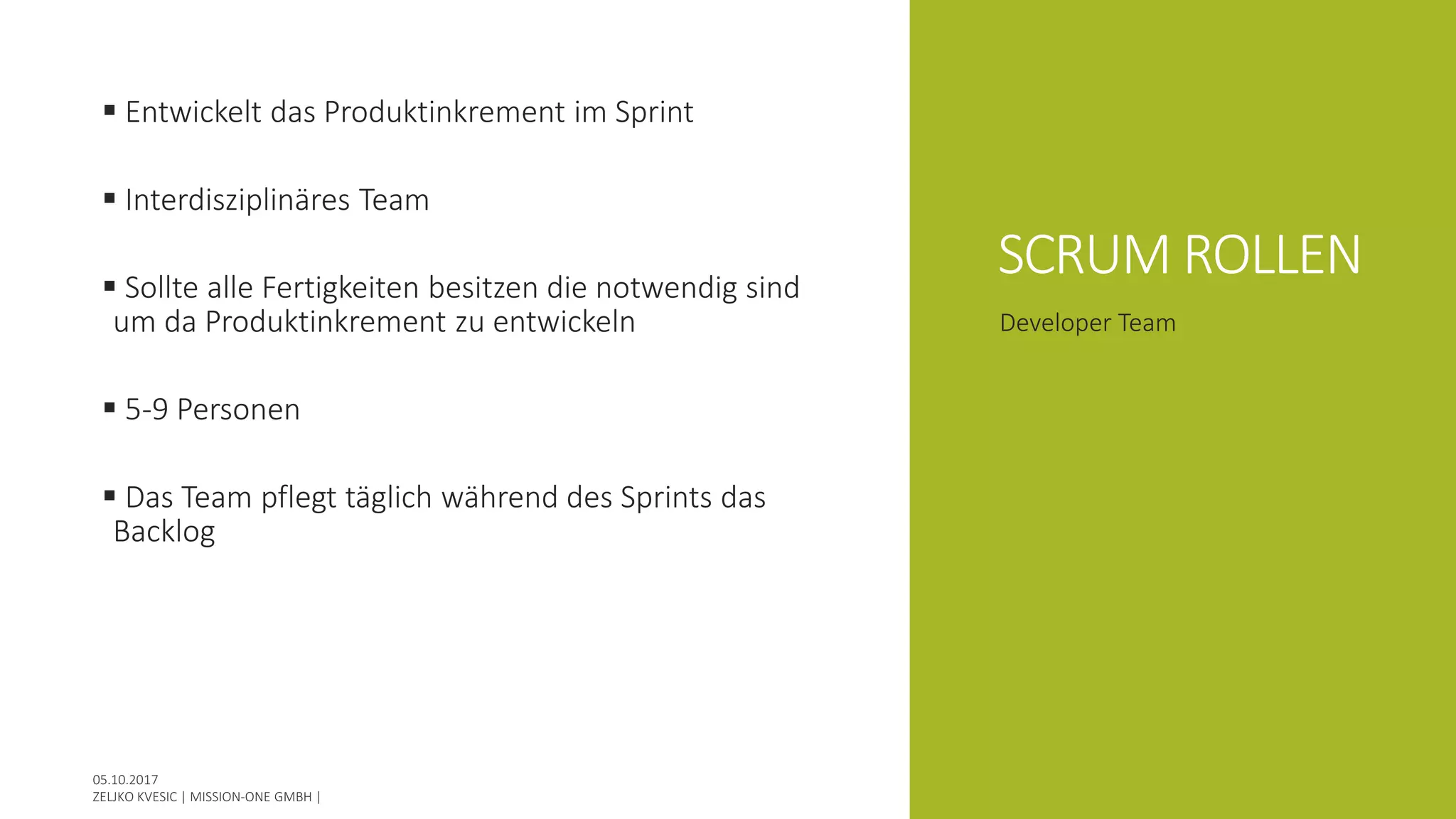

17. SCRUM ROLLEN
Entwickelt das Produktinkrement im Sprint
Interdisziplinäres Team
Sollte alle Fertigkeiten besitzen die notwendig sind
um da Produktinkrement zu entwickeln
5-9 Personen
Das Team pflegt täglich während des Sprints das
Backlog
Developer Team

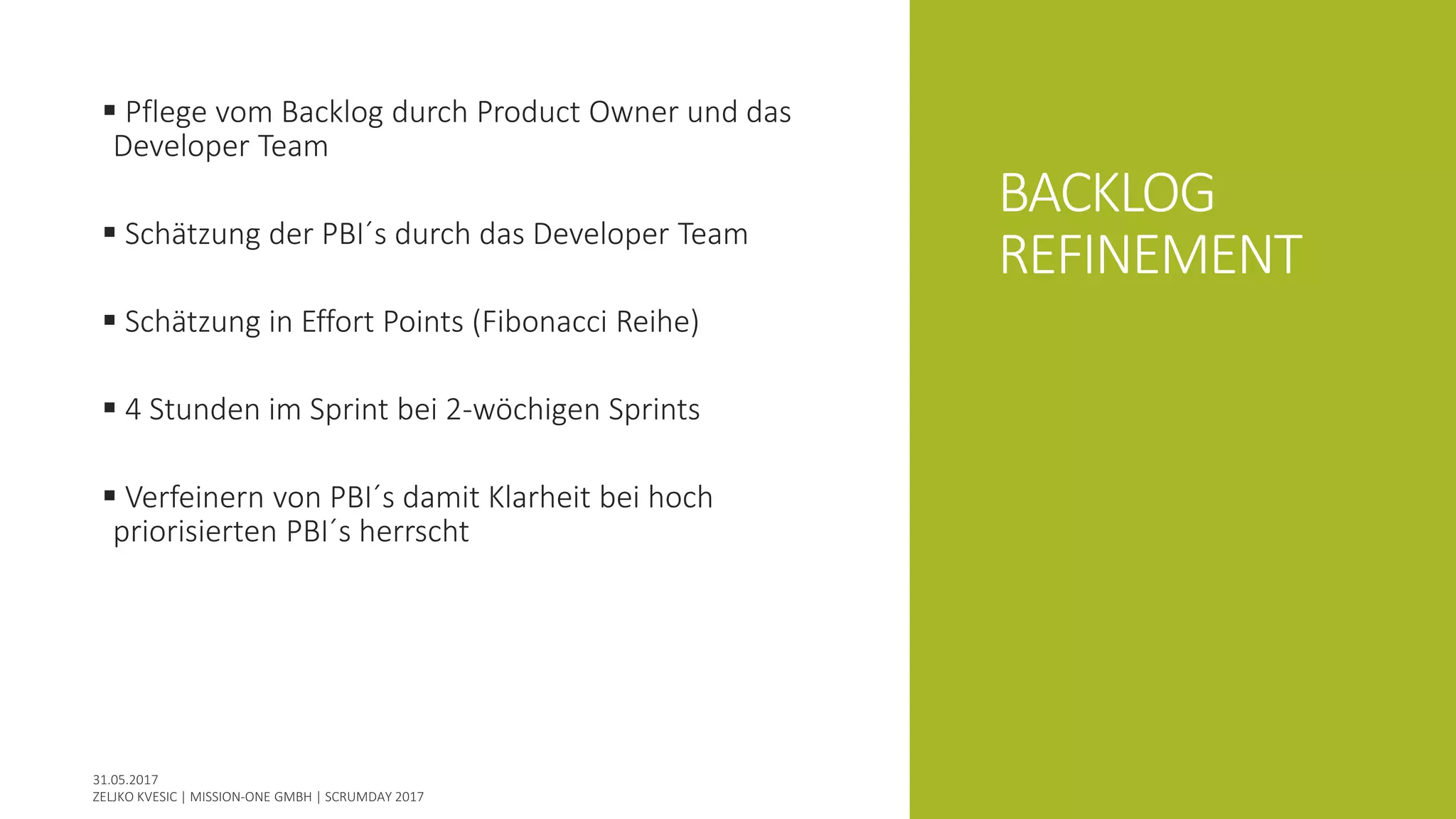

20. BACKLOG
REFINEMENT
Pflege vom Backlog durch Product Owner und das
Developer Team
Schätzung der PBI´s durch das Developer Team
Schätzung in Effort Points (Fibonacci Reihe)
4 Stunden im Sprint bei 2-wöchigen Sprints
Verfeinern von PBI´s damit Klarheit bei hoch
priorisierten PBI´s herrscht

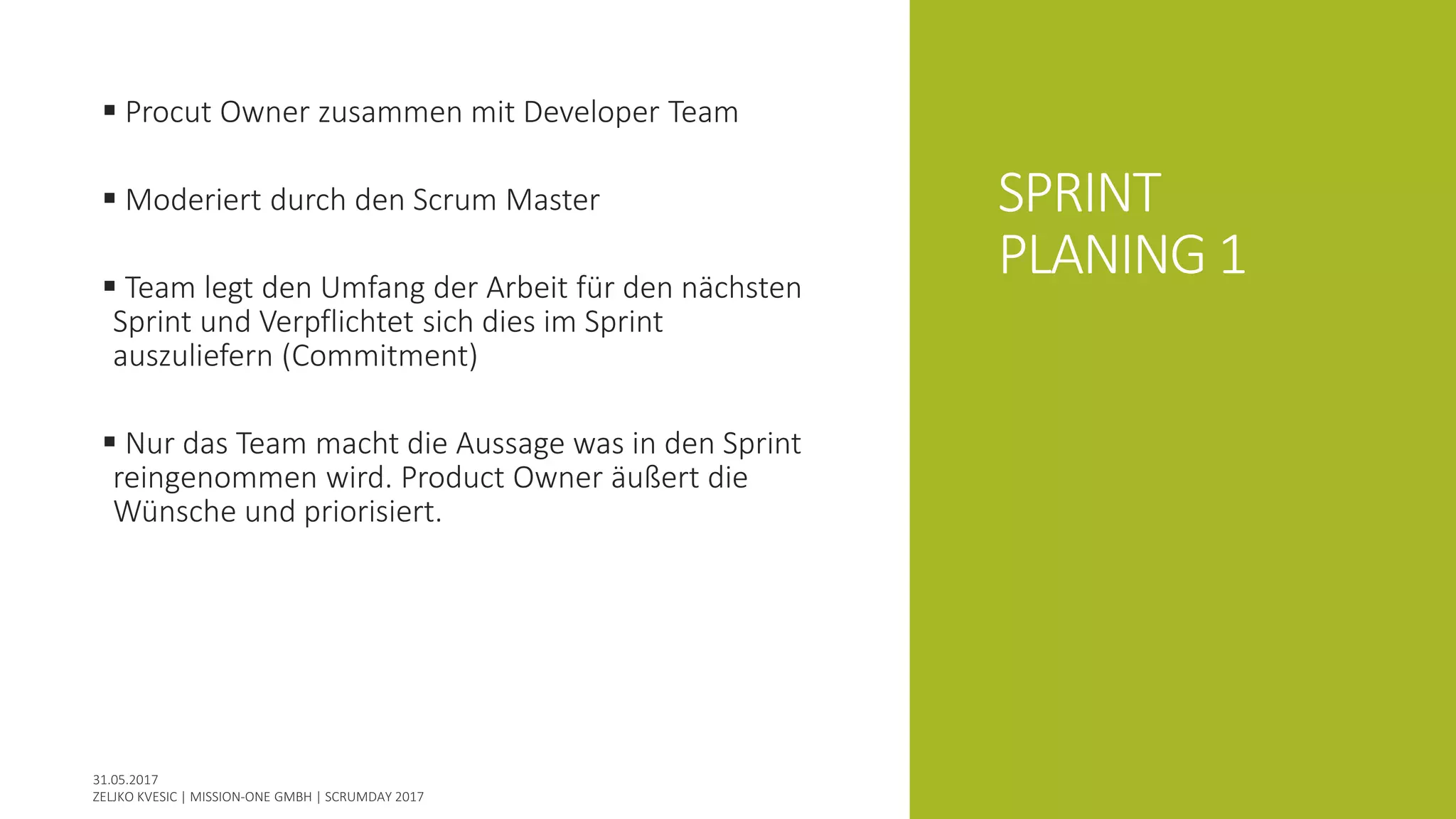

21. SPRINT
PLANING 1
Procut Owner zusammen mit Developer Team
Moderiert durch den Scrum Master
Team legt den Umfang der Arbeit für den nächsten
Sprint und Verpflichtet sich dies im Sprint
auszuliefern (Commitment)
Nur das Team macht die Aussage was in den Sprint
reingenommen wird. Product Owner äußert die
Wünsche und priorisiert.

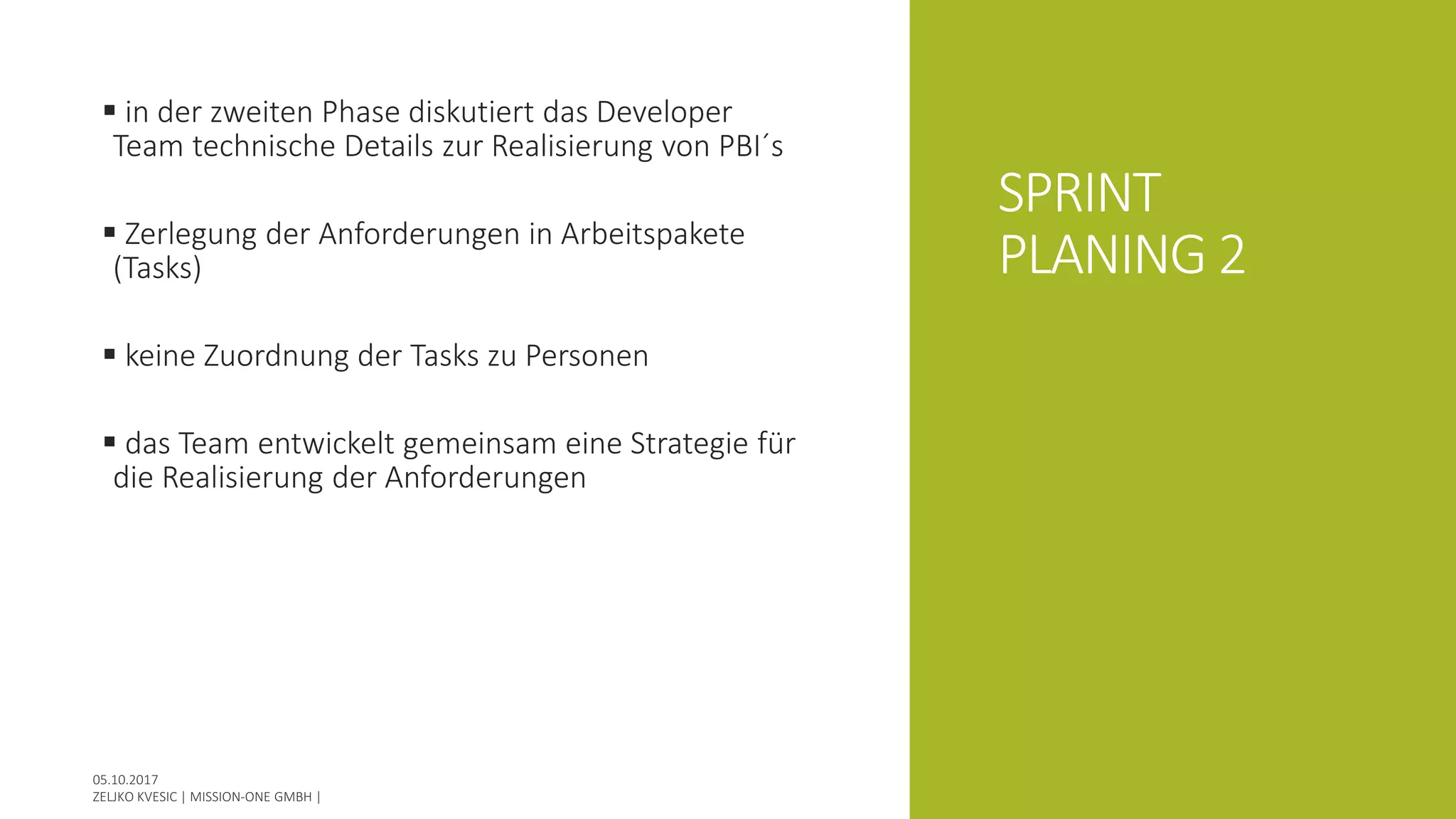

22. SPRINT
PLANING 2
in der zweiten Phase diskutiert das Developer
Team technische Details zur Realisierung von PBI´s
Zerlegung der Anforderungen in Arbeitspakete
(Tasks)
keine Zuordnung der Tasks zu Personen
das Team entwickelt gemeinsam eine Strategie für
die Realisierung der Anforderungen

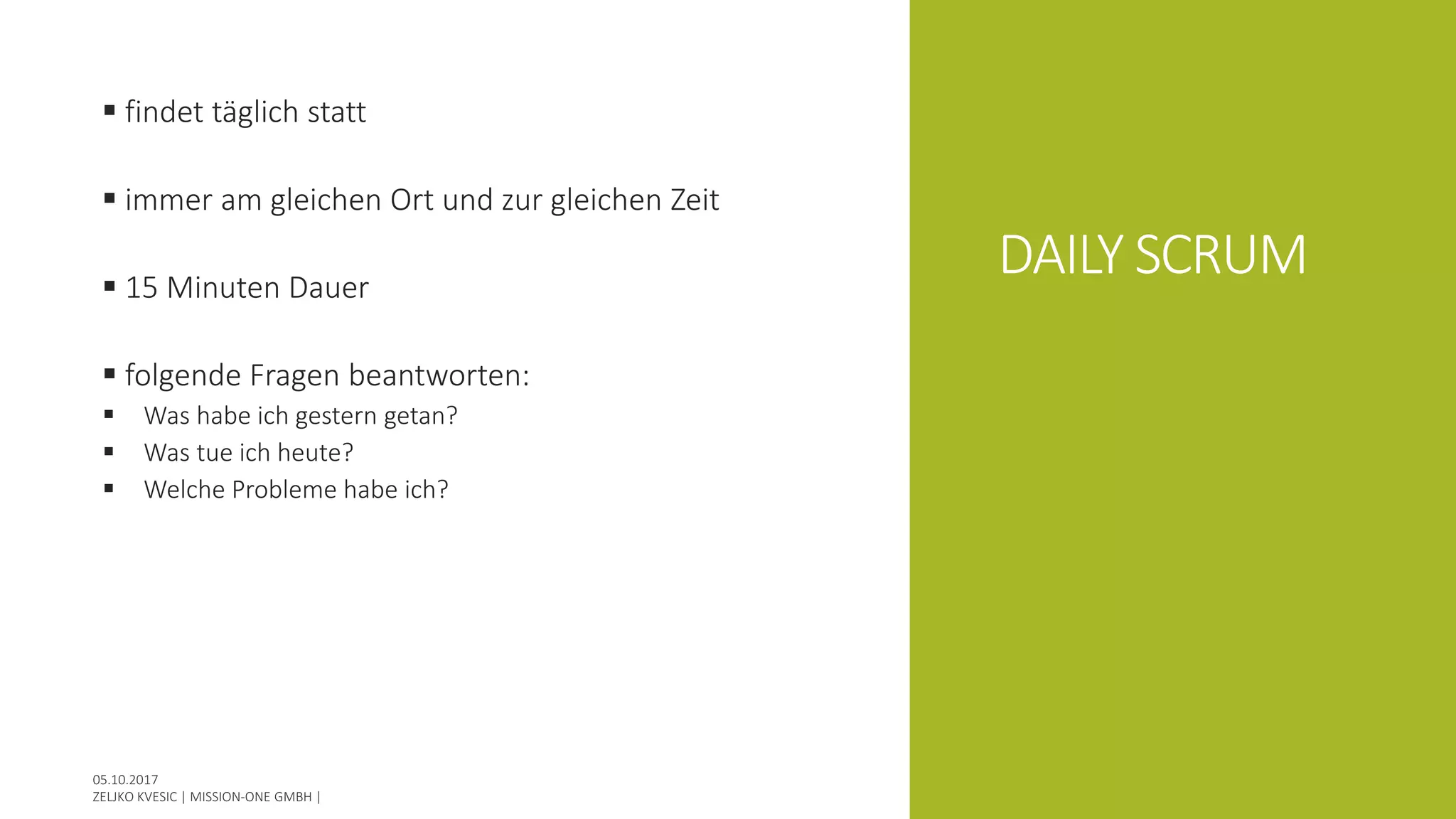

23. DAILY SCRUM
findet täglich statt
immer am gleichen Ort und zur gleichen Zeit
15 Minuten Dauer
folgende Fragen beantworten:
Was habe ich gestern getan?
Was tue ich heute?
Welche Probleme habe ich?

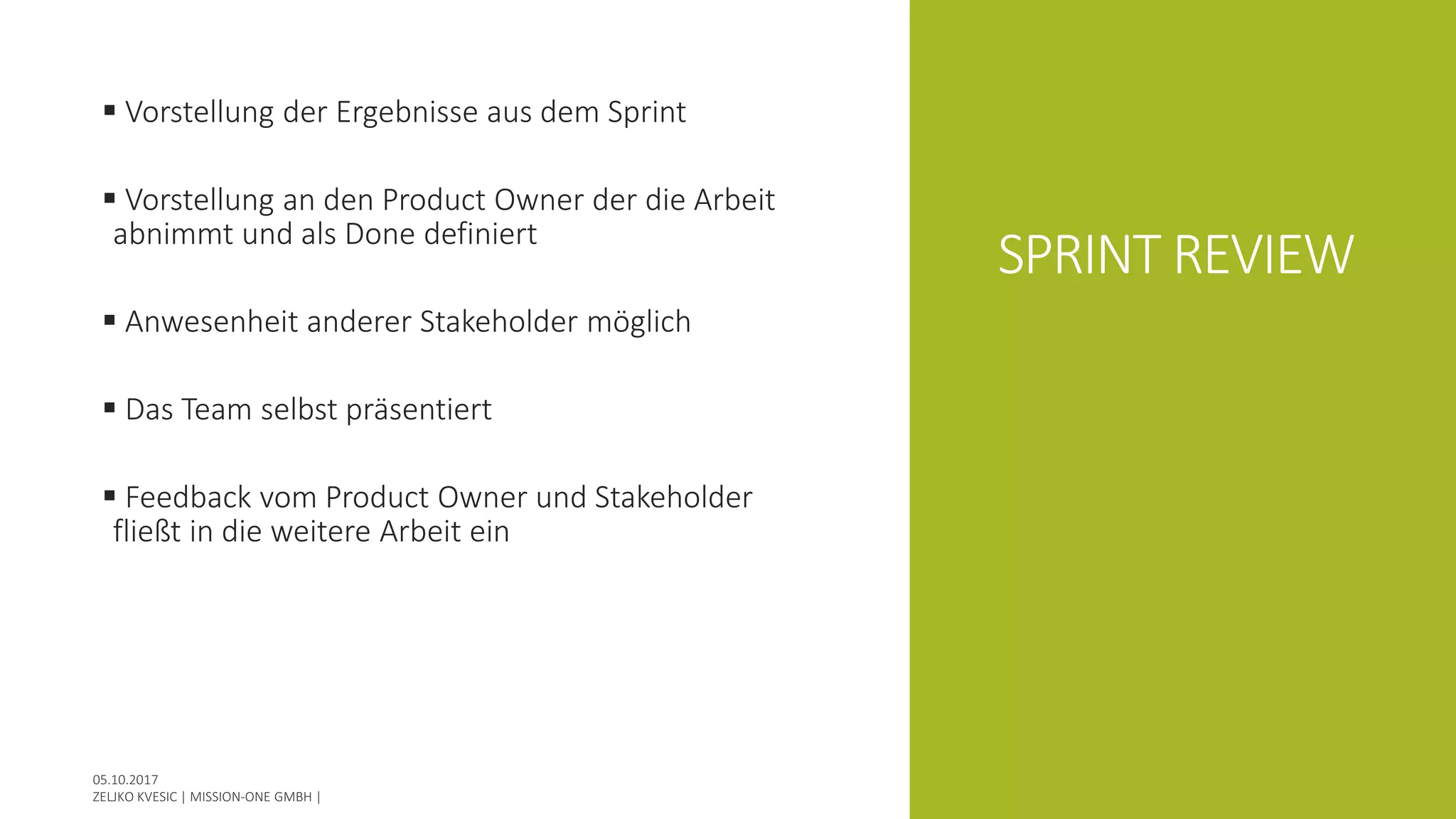

24. SPRINT REVIEW
Vorstellung der Ergebnisse aus dem Sprint
Vorstellung an den Product Owner der die Arbeit
abnimmt und als Done definiert
Anwesenheit anderer Stakeholder möglich
Das Team selbst präsentiert
Feedback vom Product Owner und Stakeholder
fließt in die weitere Arbeit ein
